Munyonyo Uganda Waterfront Hotel Apartments



Project Status

Munyoyo Waterfront Development – Project Status

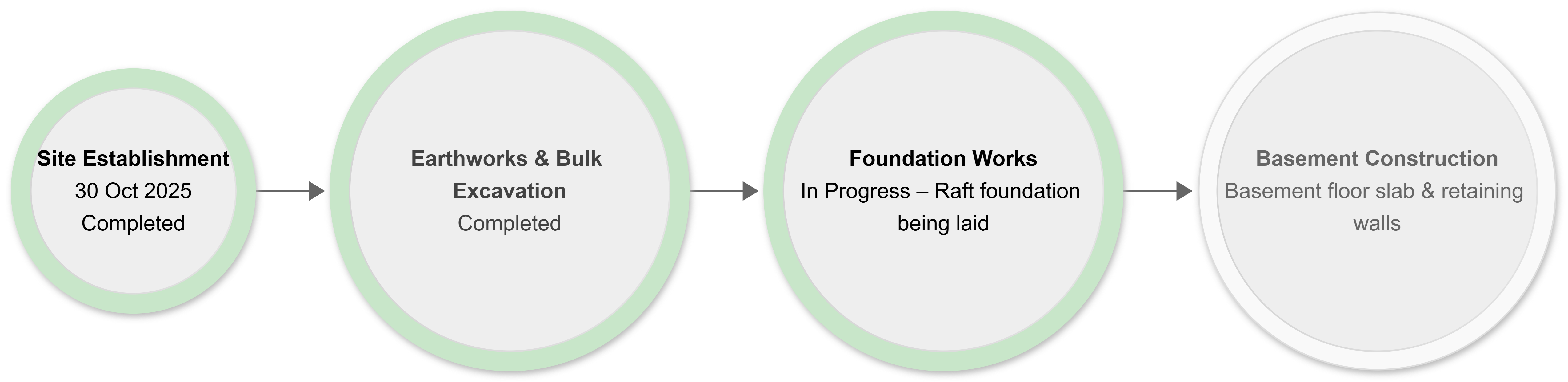

Phase Status
Site EstablishmentCompleted – 30 October 2025

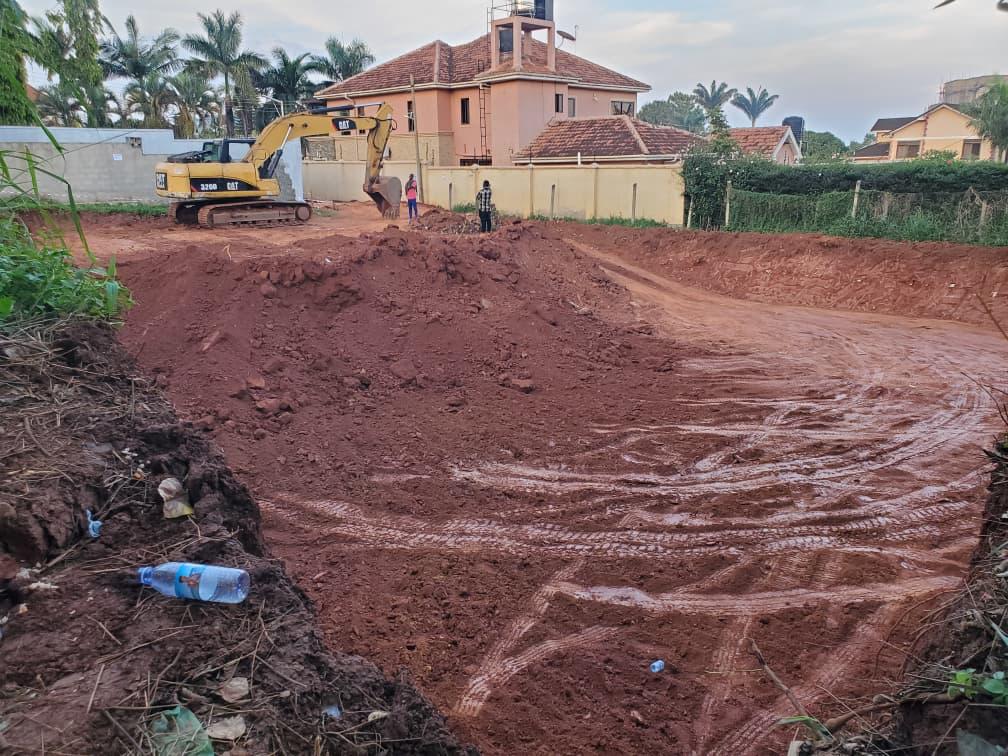

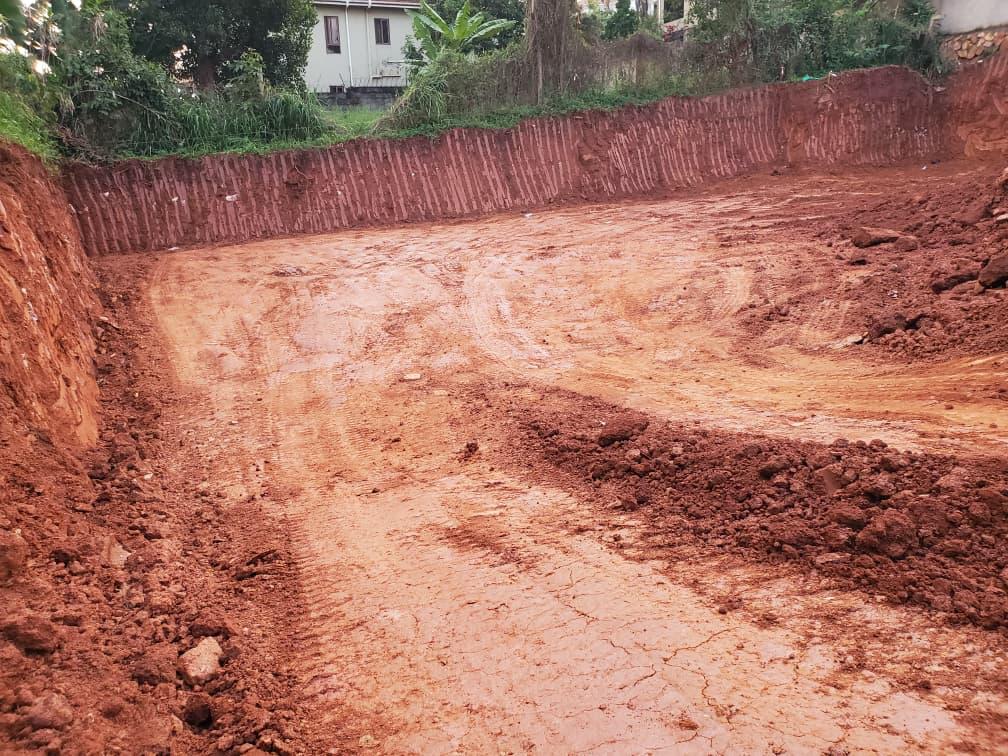

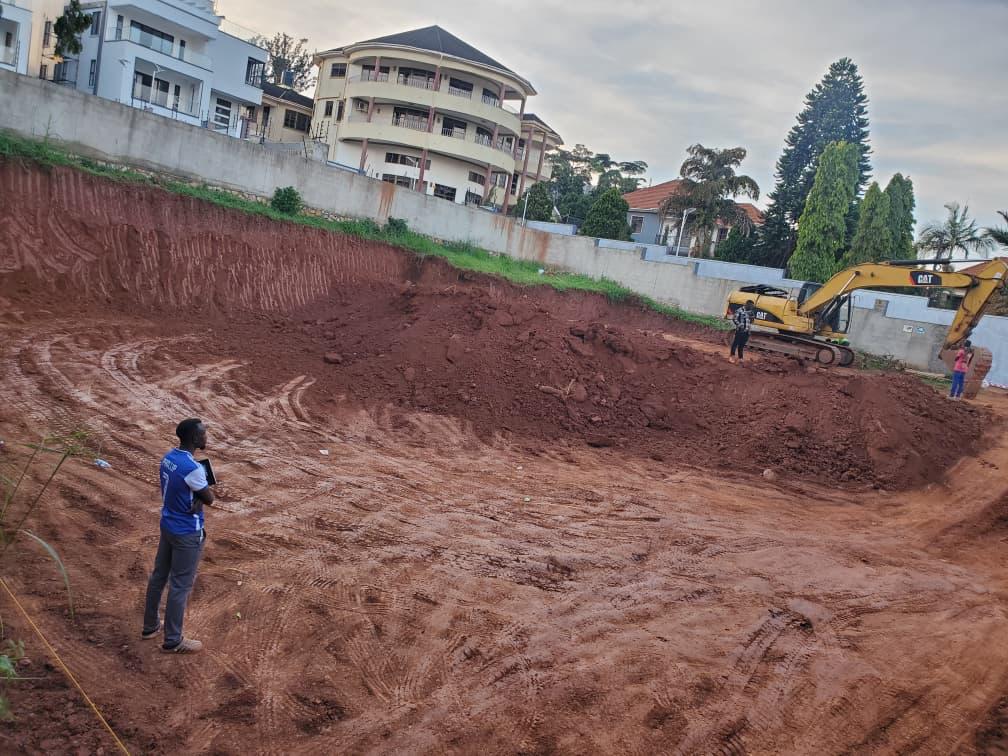

Earthworks & Bulk ExcavationCompleted
Foundation WorksIn Progress – Raft foundation being laid
Basement ConstructionUp Next – Basement floor slab & retaining walls

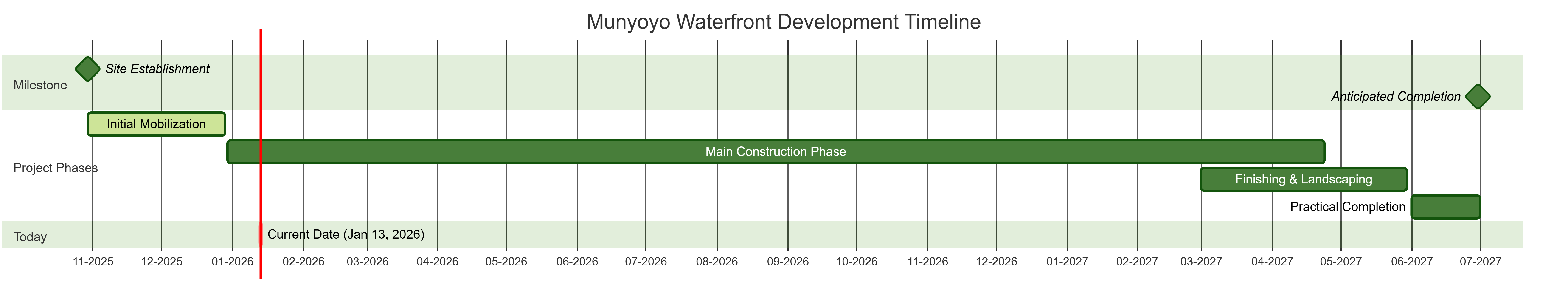

Key Milestones Ahead
16 MONTHS
Mar 2026 - Jun 2027
Milestone Target Date
Basement slab completionMarch 2026
Structural topping-outSeptember 2026
Building watertightDecember 2026
Practical CompletionJune 2027


Project Overview

Munyoyo Waterfront Development – Project Overview

Project
Munyoyo Waterfront
Developer
Coolmore Properties
Architects
Thomas W Architects
Engineers
Astratto Engineering
Quantity Surveyors
Devex
M&E Engineers
African Dynamic Engineering

Estimated Total Project Cost
US$ 8.275 million

Item Details
Project NameMunyoyo Waterfront Development
DeveloperCoolmore Properties
EngineersAstratto Engineering
ArchitectsThomas W Architects
Quantity SurveyorsDevex
Mechanical & Electrical EngineersAfrican Dynamic Engineering
Total Development Period18 Months
Anticipated Practical CompletionJune 2027
Site Establishment Date30 October 2025
Estimated Total Project CostUS$ 8.275 million


About
Munyonyo Uganda Waterfront Hotel Apartments


Waterfront apartments, is a premier luxury apartment-hotel project located in Munyonyo. The development is a JV between buildnet Uganda and Coolmore development from South Africa. The development is located in one of Kampala's most prestigious lakeside suburbs, renowned for its tranquil environment, upscale residences, and proximity to key leisure and diplomatic venues. The development is strategically positioned near the shores of Lake Victoria and within close reach of the Commonwealth Resort and Speke Resort.
VALUE: $4.8 MILLION
Features & Offerings:
The development will feature a blend of luxury serviced apartments and boutique hotel suites, combining the comforts of home with the conveniences of high-end hospitality. Amenities will include a rooftop infinity pool, wellness spa, fine dining restaurant, co-working lounges, fitness center, and conference facilities. With contemporary architecture and interior design inspired by East African elegance and modern global standards, the project targets expatriates, business travelers, diplomatic guests, and high-net-worth locals seeking exclusive long- or short-term stays.
Key highlights:
• Location: Prime address in Munyonyo, with lake views and access to key hospitality and recreation zones.
• Unit Mix: Studio, 1-, 2-, and 3-bedroom apartments; hotel suites and penthouses.
